Contract Forecasting - Projection Threshold

Setup

Screenshot of Forecasting tab on JC Control File with field highlighted.

Pgm: JCCTRLFM – Job Cost Control File; standard Treeview path: Job Costing > Setup > Local Tables > Control File – Forecasting tab

The Job cost Control File contain the Default Projection Threshold field, where users can maintain the required percent for defaulting into any new job created under the company. If no projection threshold is being used, then enter a value of zero (0.00). This field is not nullable.

NOTE: The value entered in the Default Projection Threshold % field serves as a default only when creating new jobs and is not used in any calculations.

Screenshto of Job Setup with field highlighted.

Pgm: JCJOBFM – Job Setup; standard Treeview path: Job Costing > Job > Enter Job – Job Detail tab

The value in the Projection Threshold % field on the Job Setup screen defaults from the Job Cost Control File.

This field is not nullable. When no threshold percent is required, then this field should be set to zero (0.00). In this case, no projection threshold is applied.

When there is a non-zero projection percent entered, then the value will be compared against the percent complete value in forecasting. Users can override this value at the job level as required.

Screenshot of Assign Job Cost Codes with column highlighted.

Pgm: JCPRODSU – Assign Job Cost Codes; standard Treeview path: Job Costing > Job > Assign Cost Codes

The cost code (phase) level Projection Threshold % column can be left as null on the Assign Job Cost Codes screen. If it is left as null, then the program will use the value entered at the job level in the Projection Threshold % field on the Job Setup screen. When required, users can enter an override for any specific cost codes (phase codes), which will be used on bill codes with specific cost codes.

Screenshot of Assign Job Cost Codes with column highlighted.

Pgm: JCPRODSU – Assign Job Cost Codes; standard Treeview path: Job Costing > Job > Assign Cost Codes

Calculations

If % Complete is >= Threshold %

then, no projection threshold is applicable and standard calculation applies.

If % Complete is < Threshold %

then, projection threshold is used in calculating the projected cost forecast.

Examples

Example 1: % Complete is >= Projection Threshold %

Screenshot of Job Setup.

Screenshot of Productivity pop-up.

Standard Calculation ‘P’ Lines:

Estimate To Complete = Remaining Output Units * Current Output Rate = 35.00 * 238.00 = 8,330.00

Remaining Input Quantity = Estimate To Complete / Current Input Rate = 8,330.00 / 85.00 = 98

Projected Cost =Projected Output Units * Current Output Rate = 60 * 238.00 = 14,280.00

Standard Calculation ‘U’ Lines:

Screenshot of Productivity pop-up.

Projected Cost Forecast = (Budgeted Units / Completed Units) * Completed Amount

= (200 / 70) * 5950

= 17,000.00

Estimate To Complete     = 11,050.00

Example 2: % Complete < Projection Threshold %

Projected Cost Forecast = Max {Budget, Calculated Projected Cost Forecast Amount}

Screenshot of Job Setup.

Screenshot of Contract Forecasting.

Screenshot of Contract Forecasting.

Screenshot of Contract Forecasting.

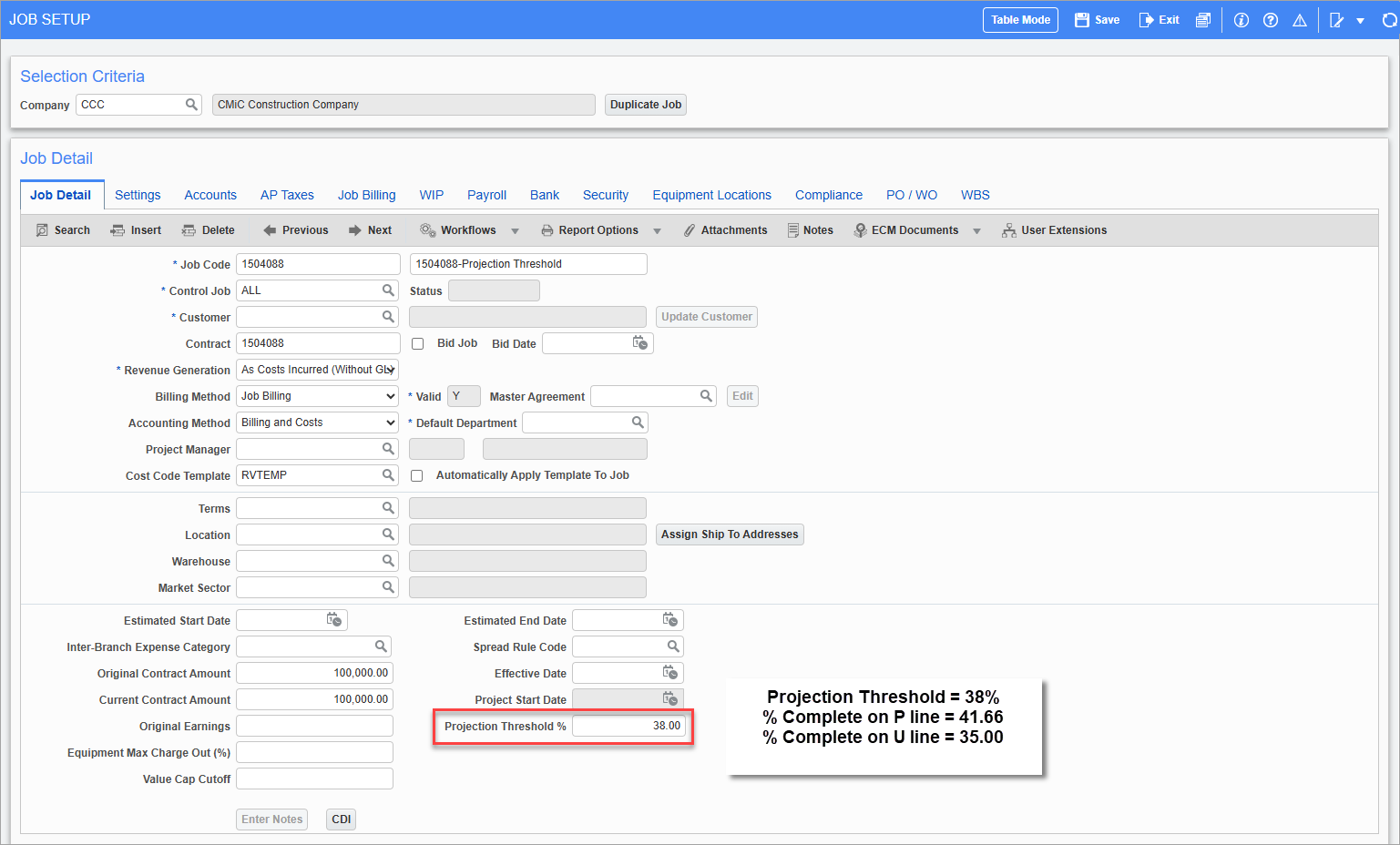

Example 3: Job Level Projection Threshold

Screenshot of Job Setup.

Screenshot of Contract Forecasting.

Example 4: Phase Level Projection Threshold

Screenshot of Assign Job Cost Code.

Screenshot of Contract Forecasting.

Screenshot of Assign Job Cost Code.

In the example above, the 100% projection threshold is greater than the % Complete. Therefore, the maximum (Budget vs. Projected Cost Amount) will be used.

Screenshot of Contract Forecasting.

Screenshot of Assign Job Cost Code.

In the example above, the projection threshold is set at zero.

Screenshot of Contract Forecasting.
